Chh. Shahu Sakhar Karkhana, Kagal, Maharashtra, India
Sugarcane-Based Distillery
| Client | Chh. Shahu Sakhar Karkhana, Kagal |
| Industry | Sugarcane-Based Distillery |
| Location | Maharashtra, India |
| System | PSF + ACF + UF + Two-Stage RO (RO1 & RO2) |
| Feed Source | Flushing Wastewater / Boiler Condensate |
| Design Capacity | 800 KLD (33.3 m³/hr) |
| UF Capacity | 25.68 m³/hr feed → 23.11 m³/hr permeate |
| RO1 Capacity | 23.11 m³/hr feed → 16.17 m³/hr permeate (70% recovery) |
| RO2 Capacity | 6.94 m³/hr feed → 3.12 m³/hr permeate (45% recovery) |
| Automation | PLC-based customised automation system |
| Membrane Make | HITEC (UF) | Hydranautics (RO1 & RO2) |
| Pump Make | Kirloskar (Horizontal) | CNP (Vertical HP) |
| Offer Reference | BlueMaarlin Techno-Commercial Offer – 30 Sep 2023 |
Shankarrao Kale Sugar Factory, a sugarcane-based distillery in Maharashtra, faced a significant challenge with approximately 5,00,000 litres of wastewater per day generated as boiler condensate and flushing water from various processing units. The large volume made simple drainage impractical and non-compliant with effluent discharge regulations.
Client's Key Requirements
| Sr. No. | Parameter | Value | Unit |
|---|---|---|---|
| 1 | TDS | ~2,500 | mg/L |
| 2 | Calcium | 450 | mg/L |
| 3 | Magnesium | 350 | mg/L |
| 4 | Sodium (as Na) | 120 | mg/L |
| 5 | HCO3 | — | mg/L |
| 6 | Sulphates (SO4) | 150 | mg/L |
| 7 | Chloride (Cl) | 1,906 | mg/L |
| 8 | Reactive Silica | — | mg/L |
| 9 | COD | <100 | mg/L |
| 10 | BOD | <30 | mg/L |
| 11 | TSS | <30 | ppm |
| 12 | Turbidity | <5 | NTU |
Note : Plant is designed on the above parameters. Performance guarantee is valid only within these limits.
Technical Challenges
Automation & Site Challenges

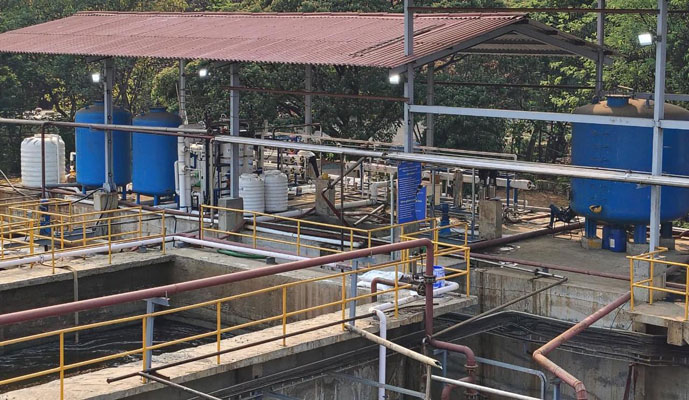

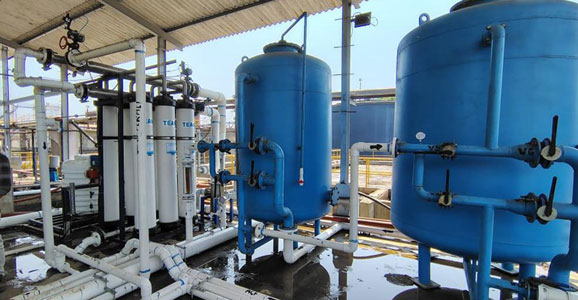

Considering the feed water parameters — particularly the high TDS, hardness, and chloride load — the BlueMaarlin team designed a multi-stage pre-treatment and polishing system: a Pressure Sand Filter (PSF) and Activated Carbon Filter (ACF) ahead of Ultrafiltration (UF), followed by a two-stage Reverse Osmosis system. This arrangement provided multiple barriers against fouling, scaling, and organic carryover to protect the RO membranes.
The UF system, using HITEC PES polymer membranes at 45 LMH flux, achieves 90% recovery at 25.68 m³/hr feed. RO Stage 1 (Hydranautics LFC-LD 8040) runs at 70% recovery, with the RO1 reject stream (6.94 m³/hr) feeding RO Stage 2. RO2 uses sea-water grade Hydranautics membranes and a high-pressure CNP pump (18.5 bar) to achieve 45% recovery, producing a final permeate of 3.12 m³/hr while concentrating the reject for ZLD or further treatment.
| System | Feed (m3/hr) | Permeate (m3/hr) | Reject (m3/hr) | Recovery |
|---|---|---|---|---|
| Ultrafiltration (UF) | 25.68 | 23.11 | 2.57 | 90% |
| RO Stage 1 (RO1) | 23.11 | 16.17 | 6.94 | 70% |
| RO Stage 2 (RO2) | 6.94 | 3.12 | 3.82 | 45% |
| Overall System | 25.68 | 19.29 | 3.82 | 75% |
| Parameter | UF Inlet | UF Outlet | RO1 Permeate | RO2 Permeate | Unit |
|---|---|---|---|---|---|
| Flow | 25.68 | 23.11 | 16.17 | 3.11 | m3/hr |
| pH | 6–7 | 6–7 | 5–6 | 5–6 | — |
| COD | <100 | <50 | <5 | <5 | mg/L |
| BOD | <30 | <10 | <5 | <5 | mg/L |
| TDS | 2,500 | — | <50 | <100 | mg/L |
| Hardness | 1,500 | — | <30 | <50 | mg/L |
| Chloride | 1,000 | — | <30 | <50 | mg/L |
| Sulphates | <200 | — | <10 | <50 | mg/L |
| Turbidity | <3 | — | — | — | NTU |
| Temperature | 35–38 | 35–38 | 35 | 35 | °C |
| Component | Specification |
|---|---|
| Feed Pump (PSF) | Kirloskar — 2 nos. (1W+1S), 25.68 m3/hr, 25m, CI, 3.7 kW |
| Sand Filter (PSF) | Dia 1400 mm × H 1850 mm, Sand Qty 2150 kg, Manual BFVs |
| Carbon Filter (ACF) | Dia 1600 mm × H 1850 mm, Carbon (900 IV) 1650 kg, Manual BFVs |
| Purpose | Removes TSS, turbidity, residual organics and chlorine before UF |
| Component | Specification |
|---|---|
| Membrane Make | HITEC |
| Membrane Model | RDMT-81XVI-MBM-100KD |
| Membrane MOC | PES (Polyethersulfone) |
| MWCO | 100 KDa |
| No. of Modules | 6 Nos. |
| Flux Rate | 45 LMH |

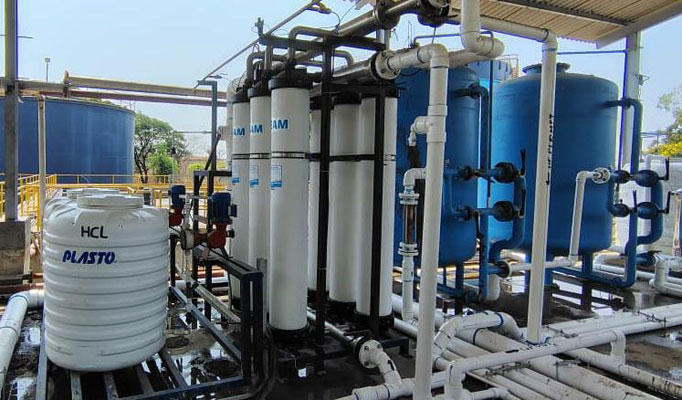

| Recovery | 90% |
| Feed Flow | 25.68 m3/hr |
| Permeate Flow | 23.11 m3/hr |
| UF Feed Pump | Kirloskar — 2 nos. (1W+1S), 25.68 m3/hr, 25m, CI, 3.7 kW |
| Backwash Pump | Kirloskar — 2 nos. (1W+1S), 84 m3/hr, 25m, CI/CF8, 22 kW |
| Basket Strainer | BMEPL SS304, 150 micron, 26 m3/hr |
| Acid Dosing Tank | Plasto HDPE, 500L, Vertical Cylindrical |
| Acid Dosing Pump | Positive Metering PP, 0–125 LPH, 3.5 kg/cm2, Electronic |
| Alkali Dosing Tank | Plasto HDPE, 500L |
| Alkali Dosing Pump | Positive Metering PP, 0–91.8 LPH, 3.5 kg/cm2, Electronic |
| Auto Butterfly Valves | Aira — 4 nos., Pneumatic Actuated, CI Body – SS Disc |
| UF Skid | MS Epoxy Painted (MSEP) |
| Piping | UPVC (feed/permeate); Feed Header UPVC |
| Component | Specification |
|---|---|
| Membrane Make | Hydranautics |
| Membrane Model | LFC-LD 8040 (Low Fouling Composite) |
| Housing Make | UKL FRP, 300 PSI rating |
| No. of Membranes | 25 Nos. |
| Feed Flow | 23.11 m3/hr |
| Permeate Flow | 16.17 m3/hr (~16.77 m3/hr design) |
| Reject Flow | 6.94 m3/hr (feeds RO2) |
| Recovery | 70% |
| RO1 Feed Pump | Kirloskar — 2 nos. (1W+1S), 23.11 m3/hr, 30m, CF8, 3.7 kW |
| High Pressure Pump | CNP — 2 nos. (1W+1S), 25.05 m3/hr, 10.7 bar, SS316, 15 kW, Vertical Multistage |
| Cartridge Filter | BMEPL SS304, 5 micron, 30" × 30E, 23 m3/hr, PP Spun |
| Acid Dosing | Plasto HDPE 500L + Positive Metering PP, 0–10 LPH, Electronic |
| Antioxidant Dosing | Plasto HDPE 500L + Positive Metering PP, 0–6 LPH, Electronic |
| Antiscalant Dosing | Plasto HDPE 500L + Positive Metering PP, 0–6 LPH, Electronic |
| HP & Reject Piping | SS304 SCH10 |
| Interconnecting Pipe | UPVC SCH40 |
| RO1 Skid | MS Epoxy Painted (MSEP) |
| Component | Specification |
|---|---|
| Membrane Make | Hydranautics |
| Membrane Model | Sea Water Grade |
| Housing Make | UKL FRP, 450 PSI rating |
| No. of Membranes | 6 Nos. |
| Feed Flow | 6.94 m3/hr (RO1 Reject) |
| Permeate Flow | 3.12 m3/hr |
| Recovery | 45% |
| RO2 Feed Pump | Kirloskar — 2 nos. (1W+1S), 7 m3/hr, 30m, CF8M, 3.7 kW |
| High Pressure Pump | CNP — 2 nos. (1W+1S), 7 m3/hr, 18.5 bar, SS316, 7.5 kW, Vertical Multistage |
| Cartridge Filter | BMEPL SS304, 5 micron, 30" × 5E, 7 m3/hr, PP Spun |
| Acid Dosing | Plasto HDPE 100L + Positive Metering PP, 0–6 LPH, Electronic |
| Antiscalant Dosing | Plasto HDPE 100L + Positive Metering PP, 0–4 LPH, Electronic |
| HP & Reject Piping | SS316 SCH10 |
| RO2 Skid | MS Epoxy Painted (MSEP) |
| Component | Specification |
|---|---|
| CIP Tank | Plasto HDPE, 2000L |
| CIP Pump | CNP — 1 no., 25 m3/hr, 40m, SS316, 7.5 kW, Horizontal |
| CIP Cartridge Filter | BMEPL SS316, 5 micron, 30" × 12E, 26 m3/hr, PP Spun |
| Instrument | Make | Location | Qty |
|---|---|---|---|
| pH Meter | Aster | RO1 | 1 |
| Conductivity Meter | Aster | RO1 and RO2 | 4 |
| ORP Meter | Aster | RO1 | 1 |
| SDI Kit | Aster | UF | 1 |
| Pressure Gauges | Waree | UF, RO1, RO2 | 24 |
| Low Pressure Switch | Danfoss | RO1, RO2 | 4 |
| High Pressure Switch | Danfoss | RO1, RO2 | 4 |
| DP Switch | Danfoss | UF | 1 |
| Mag Flow Meter | Aster | UF Backwash | 1 |
| Rotameters | Aster | UF Permeate, RO1/RO2 P & R | 5 |
| Level Switches | — | All Dosing Tanks | 8 |
| Control Panel (UF) | Aster | Matic Type MCC | 1 |
| Control Panel (RO1/RO2) | Aster | Matic Type MCC | 1 |
| PLC Automation | — | Custom PLC sequence | 1 |
| Line | MOC |
|---|---|
| UF Piping (inlet basket strainer & after each header) | UPVC |
| UF Feed Header | UPVC |
| RO1 HP & Reject Piping | SS304 SCH10 |
| RO2 HP & Reject Piping | SS316 SCH10 |
| RO Interconnecting Piping | UPVC SCH40 |
| Flanges | BS 10 Table E Standard |
Valves
BlueMaarlin Scope of Supply
Exclusions (Client / Mega Engineering Scope)
Engineering Documents
| Document | Duration from PO |
|---|---|
| P&ID Drawing | 16 days |
| Data Sheets & Technical Documents | 25 days |
| Electrical Panel Drawings | 35 days |
| Plant Layout & Skid Drawing | 20 days |
| Quality Assurance Plan | 25 days |
| Internal Quality & Painting Reports | During dispatch |
| Test Certificates of Components | During inspection/dispatch |
| O&M Manual | After commissioning |
Supply & Commissioning Timeline
| Milestone | Duration |
|---|---|
| Inspection call (without RO membranes) | 12 weeks from date of PO |
| Dispatch to site (without RO membranes) | 14 weeks from date of PO |
| Installation & pre-commissioning check | 12–15 days after site work starts |
| Commissioning | 2–3 days after installation |
UF Recovery
RO1 Recovery
RO2 Recovery
UF Recovery
Total RO Membranes
PLC Automation
